An Engineering Acceptance Plan Before the First Trial
What to witness at the factory, what to recheck at the installation site, and how to turn a demonstration into useful acceptance evidence.
A laboratory high-pressure reactor can arrive with polished stainless steel, a responsive controller and a complete-looking accessory box and still be unready for the first experiment. The missing step is often not another component. It is an agreed equipment acceptance plan: which requirements must be demonstrated, what evidence will be retained, who can approve an exception and what must be checked again after the unit reaches the laboratory.
For engineers and purchasing teams, the critical distinction is between a Factory Acceptance Test (FAT) and a Site Acceptance Test (SAT). FAT normally evaluates the agreed equipment configuration and witnessable functions before shipment. SAT confirms installation-related interfaces, site readiness and agreed functions in the actual operating environment. Neither should be confused with full process validation, nor should a successful demonstration be treated as authorization to ignore local pressure-equipment rules, risk assessments or operating procedures.
At OLLITAL, we recommend treating acceptance as an evidence trail that begins with the approved configuration and ends with a recorded decision. This guide explains how to build that trail for a high-pressure laboratory reactor without assuming every OLLITAL model has the same controls, port layout or accessories.
FAT is most useful for questions that can be answered while the reactor is still with the manufacturer. Does the delivered vessel match the approved drawing and option list? Can the supplier identify the instruments and protective components associated with the specific order? Are temperature indication, stirring and configured control functions demonstrable under the agreed test plan? Are the associated records traceable to this unit rather than to a generic catalog photograph?
SAT has a different job. A reactor that performs as expected in the factory can still encounter incompatible electrical supply, insufficient cooling capacity, unsuitable gas connections, inaccessible valves or incomplete site safety arrangements. SAT is the buyer's opportunity to confirm that the system has arrived intact, that the surrounding installation is prepared and that the agreed functional checks remain meaningful in its final location.
A useful shorthand is this: FAT asks whether the supplied system matches the agreed scope; SAT asks whether the installed system is ready for its approved operating environment. That shorthand does not replace contract terms. The parties should agree which tests belong to which stage, who witnesses them, what constitutes acceptance and what happens when a result is inconclusive.
In practice, this distinction matters because laboratory reactor configurations vary widely. The OLT-HPT laboratory high-pressure reactor family includes temperature-control and over-temperature protection functions on its product page. The flange mechanical-stirring reactor series describes a magnetic-coupling mechanical stirring arrangement with a flanged gasket seal and specific lid interfaces. By contrast, selected multi-position parallel reactor systems describe configurable independent stations, controller trends and data export. These are examples of different published configurations, not evidence that every individual unit includes every listed capability.
An effective test plan is not a generic list of boxes to tick. It is a translation of the quotation, approved drawings, purchase order and process requirements into witnessable acceptance criteria. This is where many buyers save the most time. Before a test date is booked, the buyer and manufacturer should identify the exact equipment model, vessel volume basis, required pressure and temperature duties, construction material, stirring arrangement, instrument package, connections, accessories and exclusions.
Each requirement needs a proposed method of verification. Some items are checked against documents and component identifications. Others can be demonstrated by an authorized technician through an approved functional test. Certain pressure-boundary checks need a specific procedure, suitable facilities, and competent personnel; they should not be improvised to satisfy a visitor with a camera. Where a report or certificate is expected, agree in advance which document, revision and identifying details will be supplied.
Acceptance criteria should be explicit enough to prevent disagreement. “The controller works” is ambiguous. “The specified display functions and configured alarm behavior are witnessed under the approved procedure, with the result documented against the unit identifier” is more useful. The same discipline applies to valves, ports, mixing direction, heating response, data retrieval and any optional accessories. If a function is not part of the ordered configuration, it should not appear in the test plan as a mandatory standard feature.
A small approval table in the pre-FAT package can prevent a long negotiation during the test:
| Plan item | What should be agreed before FAT? |
|---|---|
| Scope | Current model, approved drawings, option list and exclusions |
| Method | Document review, inspection, authorized demonstration or report |
| Criteria | Pass requirement, allowed tolerance where applicable, and who approves it |
| Evidence | Dated record, unit identifier, screenshots/photos or supporting document |
| Exception handling | How a deviation is logged, corrected, retested and closed |
The first witness activity should establish that everyone is looking at the correct reactor. Record the model and unit or serial identification where provided, and compare the assembled equipment against the latest approved configuration. A photograph of a reactor alone proves little if it cannot be linked to the order. The same is true of a drawing that does not show its revision or a component list that no longer matches the installed ports.
For a flanged high-pressure reactor, configuration review should include the vessel and lid assembly, closure concept, wetted construction materials, applicable gasket and sealing approach, pressure indication points and required safety-related connections. The OLLITAL flange mechanical-stirring product page identifies examples of lid ports for temperature measurement, pressure monitoring, pressure-relief components, inlet and exhaust functions. An acceptance inspection must still follow the actual ordered drawing, since different models and optional configurations do not share a universal port arrangement.
The pressure-boundary verification discussion is particularly important. Buyers should request the design or inspection documentation that applies to the purchased unit and the agreed contractual scope, and should confirm which checks were performed, by whom and under what approved procedure. Do not substitute a casual leak observation for a documented pressure test, and do not assume that a displayed pressure reading proves the integrity of the complete pressure boundary. The required tests, safeguards and documentation depend on equipment design, jurisdiction and application. Qualified personnel must determine the procedure and safe test conditions.
A useful FAT record contains an equipment identity reference, the applicable drawing revision, the verification result, the associated evidence and an authorized reviewer. If a critical record is missing, that absence belongs in the deviation register. A clean-looking vessel is not a replacement for traceable evidence.
A modern reactor controller may display a setpoint, a measured value and an actuator status; those three displays should not automatically be treated as independent proof that a process function is working correctly. An acceptance test should identify what is actually being witnessed: sensor indication, control response, data recording or a particular user-interface feature. If an independent reference instrument is part of the agreed method, document its identity and applicable calibration status.
Temperature-control review can cover the relevant sensor channels, display consistency, heating response and configured protection behavior under approved conditions. Stirring review may include the presence of the selected drive, appropriate direction indication or speed-response demonstration where specified. When a magnetic coupling is used, a demonstration of motor rotation alone does not settle questions about coupling, mixing duty and sealing suitability for a future process. Acceptance should be confined to the agreed equipment-level tests and their stated limits.
Data functions deserve similarly precise wording. The OLLITAL multi-position parallel integrated reactor describes controller-based collection of process variables, historical trends and export functions on certain configurations. That does not mean every OLLITAL reactor generates identical files or has a standard data archive. If the purchased unit includes trend recording, the FAT should establish the configured variables, the output format, the date/time behavior, file identification and whether a representative record can be retrieved. If it does not include those capabilities, the acceptance plan should say so rather than promise them.
An important distinction is demonstrated control function versus proven process performance. A successful heating or stirring check under a vendor-defined test medium does not establish that the buyer's viscous, foaming or highly reactive formulation will behave the same way. Process-specific performance requires its own authorized development and validation work.
Protective functions should never be treated as decorative items on a checklist. The buyer should know which alarms, interlocks, protective devices and operator warnings are included in the actual ordered system and how their presence and behavior will be verified. The OLT-HPT product description, for example, mentions a configurable temperature upper limit, over-temperature alarm and self power-off protection. For the multi-position parallel system, the site describes upper-limit settings and over-temperature or over-pressure alarm interlocks for certain variants. Their applicability must be checked against the actual configuration and order. Do not generalize those descriptions to every high-pressure product.
The agreed verification method must be appropriate for the equipment and carried out by competent personnel. It should not require a visitor or operator to deliberately create an unsafe overpressure or defeat a safety device for demonstration. Where a required protective test cannot be witnessed safely during FAT, the record should explain the evidence method, remaining limitation and any subsequent verification needed under a separate approved plan.
This is also where scope language matters. A pressure gauge, a relief component, an electronic trip and an operating instruction address different hazards; they are not interchangeable proof. The acceptance package should make it possible to identify which component or procedure addresses which requirement without making unsupported claims about “complete safety” or leak-free operation.

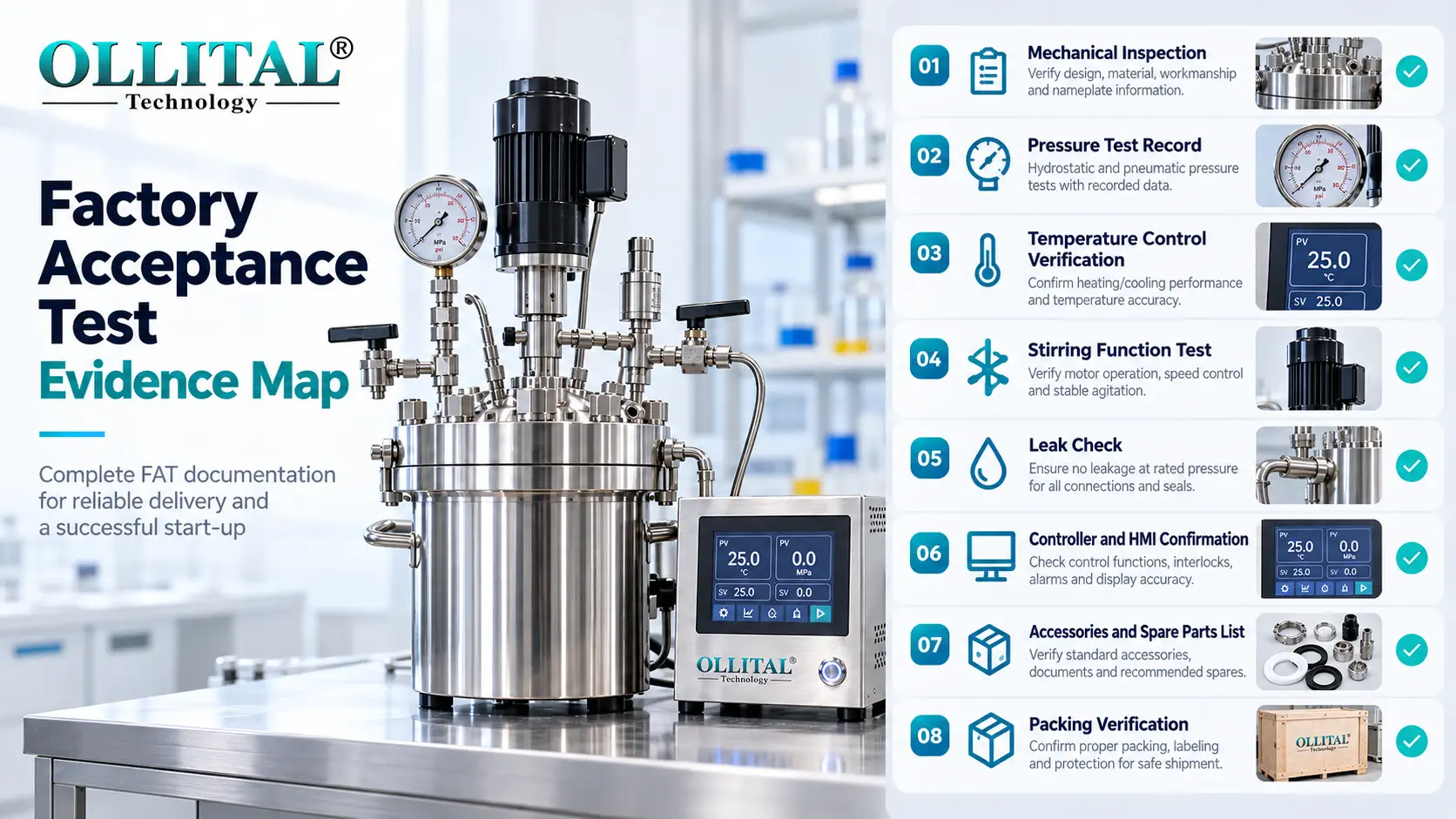

Figure 1. Example FAT evidence map: a requirement is useful only when it is tied to an observation and a record.
A useful acceptance package is compact enough to review but detailed enough to survive a staff change. For every important checkpoint, the record should state what was required, what was observed, what evidence exists and whether the result passed, failed, or remains open. Screenshots without unit identification can be ambiguous. Photographs with no view of the relevant component may have little evidentiary value. A signature with no date, revision or test scope can be difficult to interpret later.
At minimum, consider including the approved configuration list; current drawings and manuals as applicable; the witness test protocol; component or instrument identifications; relevant inspection and test records; controller screenshots or exported example data where applicable; a dated list of deviations; corrective-action evidence; and the final acceptance decision. Not every item will apply to every bench-scale reactor, but missing items should be intentionally excluded rather than silently overlooked.
An especially useful practice is to name files by the unit identifier and checkpoint rather than by an arbitrary image number. The evidence pack should explain whether the result was directly witnessed, supplied as a manufacturer's report, or scheduled for later site verification. That one distinction prevents confusion between “tested,” “reviewed,” and “still to be done.”
A deviation register should identify the affected requirement, observed discrepancy, impact on safe use, action owner, expected correction evidence and closure decision. Treat a missing decorative label differently from an unresolved pressure-boundary or protective-function issue. Severity determines whether an open item can be accepted conditionally or must hold shipment or site release. The buyer and supplier should define those decisions in their agreed acceptance process, not improvise them during a demonstration.
A retest should be traceable to the correction it verifies. Otherwise a supplier could fix one issue and provide a new photograph without documenting whether the original concern was resolved. If the correction changes the mechanical arrangement, material, port layout, safety function or instrumentation, consider whether related documentation and earlier evidence need revision too.
Shipment creates a break in the evidence chain. The reactor may be partially disassembled, connection points capped, instruments protected or accessories packed separately. FAT records should therefore be paired with a packing and configuration record that enables the receiving team to confirm what has arrived. This is particularly valuable where the vessel, control cabinet, heating arrangement, flexible lines or special sampling hardware are supplied as multiple packages.
Before shipment, confirm that the final drawing revision, user documentation and accessory inventory match the dispatched configuration. A photograph showing which fittings have been protected for transit can save time when the recipient inspects the delivery. Shipping condition should be checked without removing safety-critical protections or performing installation work outside the authorized procedure.
Documentation handover is not the same as training. The package tells the site team what the unit is; instruction and supervised commissioning establish who may install and operate it, with which procedures. When responsibilities cross from manufacturer to integrator to end user, write them down. Unassigned work between FAT and SAT can otherwise become an invisible schedule risk.
A reactor does not operate in isolation. SAT should confirm the local interfaces required by the purchased configuration: electrical supply and protection; suitable location, access and support; temperature-control utilities if needed; compatible gas supply, regulators and tubing; ventilation and hazard controls; and the planned handling of effluent or exhausted gases. Not all laboratory reactors need an external chiller, vacuum pump or gas cylinder, and those accessories must never be depicted as universal standard equipment. The site's specific process and the approved utility schedule determine what is required.
For example, a laboratory may have adequate electrical service for one simple heating configuration but not for an expanded installation with auxiliary cooling and multiple independently controlled positions. An inert-gas regulator selected for general bench use might not match the specified process interface. An inaccessible exhaust or sampling connection can create both workflow and safety issues even when the reactor itself is correctly manufactured. SAT is where the physical facility and the purchased configuration meet.
The site inspection should compare as-installed conditions against the approved installation requirements. If the local operating environment introduces an unplanned hazard, resolve that discrepancy through the authorized engineering review rather than treating it as an operator preference. Site readiness should also include an up-to-date risk assessment and applicable local requirements for pressure equipment, hazardous media, ventilation and emergency response. No short article can replace these project-specific obligations.
SAT is not necessarily a complete replay of FAT. Repeating every factory demonstration may create unnecessary work, while failing to recheck site-dependent functions leaves a real gap. The acceptance plan should distinguish between equipment characteristics already verified and functions that may have been affected by installation, reconnection, power supply, gas supply, cooling arrangements or transport.
Examples of site-relevant checks may include identity and damage inspection, agreed connections and utilities, controller power-up and display behavior, correct instrument mapping, accessibility of valves and protective components, configured logging or export functions if supplied, and training records. Which checks require a live functional demonstration, which may use a non-process medium and which must be postponed until an authorized commissioning protocol depends on the installation and associated hazards.
In the first stage, the purpose is to establish that the unit and the installation can be examined safely, not to rush into a production recipe. Personnel should not pressurize, heat, charge hazardous reagents or open pressure-containing components outside the approved operating procedure. Any suspected leak, abnormal pressure behavior or protective-function discrepancy should be treated according to the site's safe-stop and escalation process.

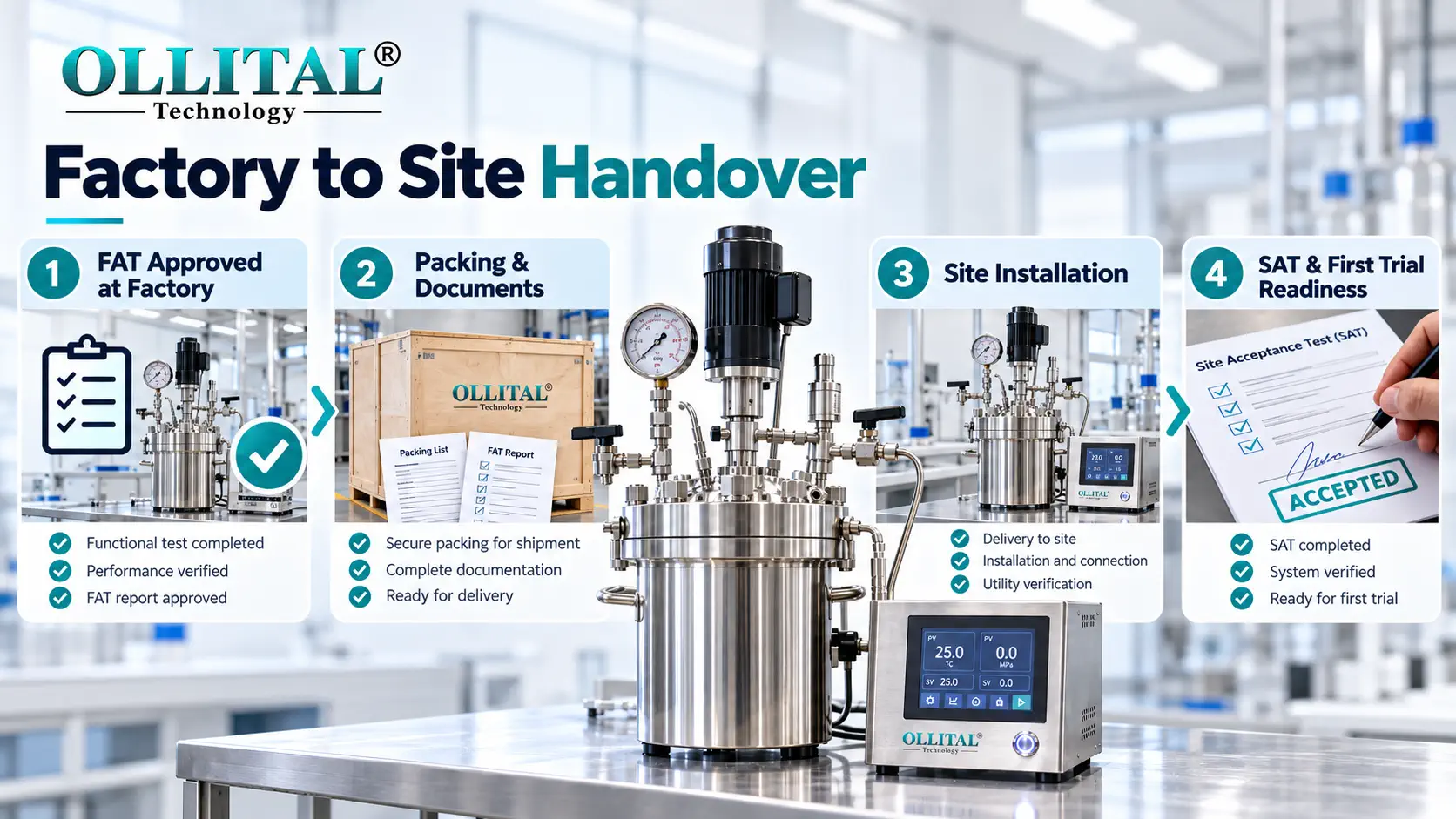

Figure 2. The acceptance chain from factory witness checks to release at the installation site.
A simple “pass/fail” checkbox sometimes hides more than it reveals. An acceptance decision should capture one of three meaningful outcomes. Accepted means the required criteria have been met and the agreed records are complete. Accepted with conditions means narrowly defined non-critical items remain, with approved owners and deadlines, and the buyer has documented the limits of this acceptance. Hold means a critical requirement, safety concern or evidentiary gap prevents release to the next stage.
The parties should not use conditional acceptance to bypass unresolved pressure integrity, protective functions or safety-critical installation requirements. Whether shipment may proceed with open items and whether operation may begin are separate decisions; one should not automatically imply the other. Site release is also distinct from process qualification. A reactor can be accepted as equipment while the buyer's chemistry, stirring regime or sampling method still requires separate development work.
This approach keeps the record useful to the people who inherit the equipment. A new lab engineer can see the baseline configuration, outstanding actions and responsibilities without relying on the memory of a commissioning meeting.
Before approving a purchase order or FAT agenda, ask whether the following questions can be answered directly from the documents and the proposed test plan:
| Buyer question | Why it matters |
|---|---|
| Can every required function be traced to the order? | Prevents testing an advertised option that is not actually included |
| Is every test result linked to this unit and revision? | Avoids generic screenshots or unrelated certificates |
| What requires a witness, a report or a later site check? | Separates direct observation from supplier documentation |
| Who is responsible for each deviation and retest? | Prevents unresolved items disappearing between FAT and SAT |
| Which site utilities and protections are assumed? | Exposes incompatibilities before the first trial |
| Who authorizes the final release to operation? | Makes equipment acceptance distinct from process authorization |
The right number of test points varies with the reactor. What should not vary is the logic: requirement, evidence, decision. Even a small laboratory system benefits from that structure, while multi-position or customized equipment usually needs a more extensive agreement about each station, shared utility, and optional control function.
If you are discussing a new reactor purchase, send the approved or proposed configuration, intended media and duty envelope, required installed utilities, port and sampling arrangement, requested documentation and any buyer-specific acceptance expectations. If your laboratory has a required FAT format or SAT handover process, share it before quotation scope is finalized. The earlier these expectations are discussed, the easier it is to determine what belongs to the equipment package and what belongs to the customer's installation and operating responsibilities.
The lab-scale stainless steel high-pressure reactor, flange mechanical-stirring reactor and multi-position parallel reactor system are useful starting points for clarifying different equipment architectures. Compare their published descriptions with the model and options on your actual quotation rather than assuming feature parity across the whole catalog.
A credible high-pressure reactor FAT and SAT plan creates continuity from procurement to installation. It confirms identity and scope, links witnessed functions to evidence, makes deviations visible and prevents an attractive factory demonstration from becoming a substitute for site readiness. The result is a cleaner handover for buyers, integrators, lab managers and the engineers responsible for the first authorized trial.
Need to turn your reactor configuration into an acceptance plan that can be reviewed before shipment?
Share the proposed model, configured options, process duty, utility conditions, required documents and any internal FAT/SAT criteria. OLLITAL can then review your equipment requirements and discuss an appropriate scope without assuming that all reactor configurations require the same tests.
